How Many Retaining Wall Blocks Do I Need? Blocks, Caps, Base Gravel and Drainage

Segmental retaining wall with blocks, cap units, base aggregate, drainage gravel and drain pipe ready for a material estimate
The visible blocks are only one part of a retaining wall order. A useful takeoff also separates buried courses, caps or coping, compacted base aggregate and free-draining stone behind the wall.

A retaining wall can look wonderfully simple from the garden: a neat stack of blocks holding back a slope. Then the shopping list starts. The bottom course disappears below grade, the cap units turn out to be a different size, the base needs its own compactable aggregate, and the space behind the wall can consume far more drainage stone than the face of the wall suggests.

This guide is for segmental retaining walls built from manufactured dry-stacked retaining wall units, often shortened to SRW. The goal is not to design the wall from the internet. It is to turn a known wall layout and a chosen block system into a material quantity that you can actually compare with a supplier quote in the United States, Canada, the United Kingdom, Ireland, Australia or another English-speaking market.

Quick answer: count blocks by courses, not by wall area alone. Blocks per course = wall length ÷ installed block face length, rounded up. Visible courses = exposed wall height ÷ course height, rounded up. Add the required buried course or courses, multiply the two counts, add a sensible material allowance and round up again. Caps, base aggregate and drainage aggregate should be calculated separately.

A material estimate is not a retaining wall design. Soil, wall height, surcharge loads, slopes, groundwater, drainage, foundation conditions, block connection, geogrid and local requirements can change what is safe to build. Use the selected manufacturer's current installation details or a project-specific design before excavation.

From wall dimensions to a complete retaining wall order

Start With the Wall System, Not Square Footage

The phrase retaining wall block covers many products. Some units are small garden-wall blocks, some are heavier segmental units with lips or pins, and some systems use large modular blocks or engineered connections. Two blocks with a similar-looking face can have different course heights, setbacks, core-fill requirements, cap sizes, minimum radii and permitted wall heights.

First identify what you are actually building

Wall typeQuantity methodImportant distinction
Segmental retaining wall (SRW)Count retaining wall units by course, then add caps, base and drainage materialsThis is the wall type covered by this guide
Mortared concrete block or CMU wallUse modular block face area, mortar joints and masonry detailsA CMU wall is a different construction system
Poured concrete retaining wallCalculate concrete, reinforcement, formwork and footing quantitiesThere is no face-unit block count
Timber, sleeper, crib or boulder wallCount the specific structural members or stonesGeometry and structural behaviour are different
Building a masonry wall instead? See How Many Concrete Blocks Do I Need?

The Measurements You Actually Need

For a straight wall, the basic block count needs only three dimensions: wall length, exposed wall height and the installed face dimensions of the block. A useful shopping list needs a few more. Write them down before opening a calculator so you do not quietly mix a supplier's nominal product name with the dimensions that control the layout.

Retaining wall takeoff inputs

InputWhat to measure or copyWhy it matters
Wall lengthThe actual run along the face of the wallControls blocks per course, cap count and all linear material quantities
Exposed wall heightFinished grade at the front to the finished top of the block wallControls the visible number of courses
Block face lengthInstalled length of one regular wall unitControls blocks per course
Course heightVertical height added by one installed courseControls the number of courses
Block depthFront-to-back unit depthHelps define the base and excavation detail
Buried coursesCourses below the finished ground in frontThey are easy to forget because they disappear from view
Cap or coping lengthInstalled length of the selected top unitCaps may not match the regular block length
Base width and compacted depthDimensions from the selected wall detailControls the compacted leveling-pad quantity
Drainage-zone thicknessSpecified free-draining zone behind the unitsControls drainage aggregate volume
Material allowanceReserve for cuts, breakage, curves and orderingConverts the neat geometric count into a practical purchase

Use installed face dimensions

Retaining wall block diagram showing face length, course height, visible courses and one buried course

Block face length determines how many units fit across one course.

Course height determines how many rows are needed vertically.

Block depth affects base and wall-section geometry but does not by itself determine the face-unit count.

Buried courses are part of the installed wall even though they are not visible after grading.

If the supplier states blocks per linear foot, blocks per metre or units per pallet for the exact product, keep those figures beside your own calculation as a cross-check. The product data wins over a generic internet block size.

1. Count Retaining Wall Blocks by Courses

Blocks per course = ceil(wall length ÷ block face length)
Visible courses = ceil(exposed wall height ÷ course height)
Total courses = visible courses + buried courses
Base block count = blocks per course × total courses
Order quantity = ceil(base block count × (1 + allowance ÷ 100))

The two round-ups matter. If a 30 ft wall needs 22.5 blocks across one row, the wall does not become 29 ft 4 in long because the spreadsheet dislikes fractions. That row needs 23 block positions, and the same issue can repeat on every course. Counting only total wall area can hide that repeated end cut.

How many 16 × 6 in face blocks are needed for a 30 ft long retaining wall that is 3 ft high, with one buried course and 10% allowance?

Answer: The wall needs 23 blocks per course. A 3 ft exposed height equals six 6-in visible courses, and one buried course makes seven courses in total. Seven courses × 23 blocks = 161 blocks before allowance. Adding 10% gives 177.1, so the purchase estimate rounds up to 178 regular wall blocks.

Explanation: Thirty feet is 360 in. Dividing 360 by the 16 in block face gives 22.5, which rounds up to 23. The course-by-course method captures both the partial end unit and the buried row below grade.

What is the same style of calculation for a 6 m long wall, 0.9 m high, using 400 × 150 mm face units, one buried course and 10% allowance?

Answer: The wall uses 15 blocks per course. The 0.9 m exposed height gives six 150 mm visible courses, plus one buried course for seven total courses. That is 105 blocks before allowance and 115.5 after 10%, so the order estimate is 116 regular blocks.

Explanation: The arithmetic is identical in metric units. Keep all dimensions in the same unit before dividing, and round the final purchasing quantity up to complete units.

Half a Block Has Excellent Attendance

  1. Dera Builderhands-on view of outdoor construction

    The calculation says 22.5 blocks per course. I was hoping the half block would only be needed once.

    It appears the half block has enrolled in every row.

  2. Dera Plannerplanning, budget and common sense

    That is why we round the row before multiplying the courses.

    A fractional block can become an offcut. A fractional delivery cannot become a full wall.

Calculate blocks, caps, base gravel and drainage stone

2. The Buried Course Changes the Order

Exposed wall height is not always the same as installed block height. Many segmental systems place part of the base course below the finished ground in front of the wall. That embedment helps protect the toe of the wall and is part of the manufacturer's installation geometry, so those blocks belong in the order even though nobody will admire them after the garden is finished.

The HomDera Retaining Wall Calculator uses one buried course as a default planning value, but it is editable. Do not treat one course as a universal rule: required embedment can depend on the block system, wall height, grading, erosion risk, slope and project design.

Visible height versus installed height

TermIncludesUse
Exposed heightThe portion visible above finished grade at the frontChoosing the visible number of courses
Buried heightOne or more courses or part of the base course below gradeEmbedment and total block quantity
Installed block heightExposed height plus buried block heightDrainage-zone and section calculations
Cap thicknessDepends on whether the cap is counted as part of the stated finished heightConfirm on the drawing before ordering or setting grade

3. Count Caps or Coping Separately

The top row is often a different product. In North American catalogues it may be called a cap block or cap unit. In the UK and Ireland you may also see coping, coping stone or coping unit. The name changes; the calculation does not. Divide the wall length by the installed length of the actual top unit, then round up and add only the allowance justified by the layout.

Cap positions = ceil(wall length ÷ installed cap length)
Purchase caps = ceil(cap positions × (1 + cap allowance ÷ 100))

How many 16 in caps are needed across a straight 30 ft wall?

Answer: Thirty feet is 360 in, so 360 ÷ 16 = 22.5 and the layout needs 23 cap positions before any reserve. If the same 10% purchasing allowance is appropriate for that exact cap layout, 23 × 1.10 = 25.3, which rounds to 26 caps.

Explanation: Caps are frequently cut at the ends, corners, curves and steps. Their waste should be checked from the real top-course layout rather than automatically copied from the regular-block percentage.

Check whether corner caps, end caps or coping pieces are separate SKUs. A perfect total-piece count can still be the wrong order when the last four units are supposed to turn a corner and every piece on the pallet is identical.

4. Base Gravel and Drainage Gravel Are Two Different Quantities

This is where many retaining wall estimates become suspiciously cheap. The stone beneath the blocks and the stone behind the blocks perform different jobs. The base or leveling pad must form a stable, level, compacted platform. The drainage zone behind the wall is intended to let incidental water move through a free-draining material instead of building pressure immediately behind the face.

Do not combine the two gravel lines

MaterialMain jobTypical handlingNames you may hear
Base / leveling-pad aggregateCreate a stable, level support under the wallPlaced and compacted to the selected wall detailCompacted aggregate, road base, granular base, crusher run, Type 1 or another specified base product
Drainage aggregateCreate a free-draining zone behind and sometimes within the block systemPlaced to the system detail; the material specification may differ from the compacted baseWall rock, clean stone, drainage stone, drainage gravel, shingle or single-size aggregate
Reinforced backfillForm the engineered soil mass when geogrid is usedPlaced and compacted to the designNot the same quantity as a narrow drainage column

The hidden half of the retaining wall

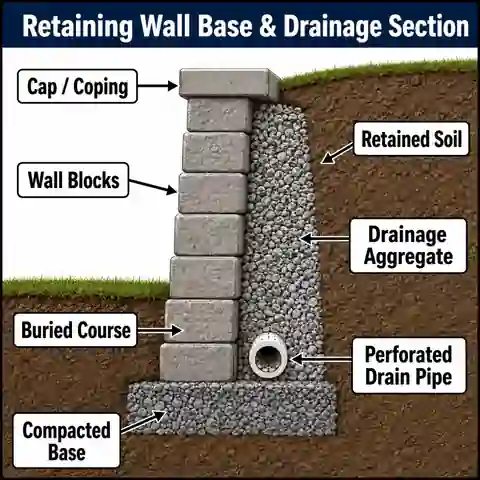

Retaining wall cross section showing cap, block courses, buried course, compacted base, drainage aggregate, perforated pipe and retained soil

The compacted base sits below the first installed course and must match the selected wall-system detail.

A buried course can increase both block quantity and the installed height used in the wall section.

Free-draining aggregate occupies a vertical zone behind the blocks and can require several times the volume of the base layer.

A drain pipe is useful only when its route and outlet are part of the water-management plan.

Names such as crusher run, road base, Type 1, clean stone and shingle are regional descriptions, not universal specifications. Confirm grading, fines, compaction suitability and drainage use for the exact material with the wall manufacturer, designer or supplier.

How Much Base Gravel Do You Need?

Once the approved base width and compacted depth are known, the volume is simple. Multiply wall length by base width by compacted depth, then add the chosen ordering allowance. Convert the result into cubic yards, cubic metres, tonnes or short tons only after the geometry is correct.

Base volume = wall length × base width × compacted base depth
Order volume = base volume × (1 + allowance ÷ 100)

What base-stone volume does the HomDera planning geometry give for the 30 ft wall example?

Answer: Using the calculator's medium 10 in deep block, a planning base width of about 22 in and a 6 in compacted base depth, the geometric volume is about 1.02 yd³. With a 10% material allowance, the order estimate is about 1.12 yd³ before converting to supplier weight or delivery units.

Explanation: The HomDera calculator derives a quick leveling-pad width from block depth plus roughly 12 in of total working width. This is a planning model, not a universal installation detail. Replace those dimensions with the selected product's actual base specification when known.

Convert a known aggregate area and depth into volume, tonnes, short tons, bags and cost

How Much Drainage Stone Goes Behind the Wall?

For a quick straight-wall takeoff, the drainage zone can be treated as a long rectangular prism. Multiply the wall run by the specified drainage-zone thickness and the installed height through which the zone continues. Some block systems also require aggregate in hollow cores or have special chimney drains, blanket drains or reinforced zones, so the simple rectangle is only a starting model.

Simplified drainage volume = wall length × drainage-zone thickness × installed block height
Order volume = drainage volume × (1 + allowance ÷ 100)

How much drainage aggregate does a 12 in zone use behind the 30 ft × 3 ft wall example?

Answer: With one buried 6 in course, the installed block height is 3.5 ft. A 30 ft × 1 ft × 3.5 ft drainage zone contains 105 ft³, or about 3.89 yd³. Adding 10% gives about 4.28 yd³ of drainage aggregate in this simplified model.

Explanation: That is almost four times the example base-stone volume. It explains why a retaining wall shopping list that includes only blocks and one small pile of base material can look accurate while still being badly incomplete.

The Gravel Was Not in the Beauty Shot

  1. Dera Builderhands-on view of outdoor construction

    I spent twenty minutes choosing between two block colours and about twelve seconds thinking about the stone behind them.

    The stone has responded by becoming the largest pile on the driveway.

  2. Dera Plannerplanning, budget and common sense

    Retaining walls are very good at hiding the materials that make the invoice interesting.

    We calculate the invisible parts before the delivery truck introduces them personally.

Convert Gravel Volume to Tons or Tonnes Last

Bulk aggregate may be sold by cubic yard, cubic metre, US short ton, metric tonne, bulk bag or truckload. Volume is the stable part of the calculation because it comes from the wall geometry. Weight depends on the actual aggregate grading, source and moisture condition.

The HomDera retaining wall calculator uses an approximate loose aggregate density of 1,600 kg/m³, roughly 100 lb/ft³, as a purchasing cross-check. For the final order, use the conversion or bulk density supplied for the exact aggregate you are buying.

Drainage Pipe Needs Somewhere to Discharge

Adding perforated pipe behind a wall does not automatically solve a water problem. The pipe has to belong to the wall system, sit at the correct elevation and lead water to an allowed outlet. In different markets you may hear perforated drain pipe, land drain, drainage pipe, agricultural drain or tile drain. The correct diameter, grade, outlet spacing and connection detail are project-specific.

Water-management questions to answer before ordering pipe

QuestionWhy it matters
Where can the collected water legally and safely go?A pipe with no effective outlet can simply store water behind the wall
Does the selected wall detail require a toe drain, another drain or no pipe in this condition?Requirements vary with the system and project
Can surface runoff be diverted before it reaches the retained soil?A wall drain should not be asked to become the site's only stormwater system
Is groundwater or a persistent seep present?That can require a project-specific drainage and geotechnical response
Will the outlet remain accessible?A buried or blocked outlet is difficult to inspect and maintain

Do not use a material calculator to invent a drain slope or pipe diameter. A perfectly measured pipe can still be useless if the outlet is too high, blocked or prohibited where you intend to discharge it.

Geogrid: Do Not Guess It From Wall Height Alone

Geogrid extends reinforcement into the soil behind some segmental retaining walls. Its number of layers, elevations, length and connection to the block cannot be determined safely from one simple formula such as one layer every X courses. Wall height matters, but it is only one input.

  • A driveway, parking area, building or other surcharge close to the top of the wall
  • Ground that slopes upward behind the wall or drops steeply in front
  • Soft, wet, filled or uncertain foundation soils
  • Persistent water, groundwater or a restricted outlet
  • Terraced walls that interact with one another
  • Sharp corners, steps or unusual wall geometry
  • A wall approaching the reinforcement limits of the selected product system
  • Consequences of failure for a building, road, utility, public area or neighbouring property

Around 4 ft (1.2 m) is a common point where retaining-wall manufacturers begin discussing reinforcement or engineered solutions, but it is not a universal permit or geogrid threshold. A shorter wall with a heavy surcharge or difficult soil can require more design work than a taller wall in simple conditions.

Curves, Corners and Steps Change the Arithmetic

A straight wall is the easy case. A curved wall changes the true face length and may approach the product's minimum radius. Inside and outside corners can need special units or alternating layouts. A wall that steps up a slope needs the base course to step with the grade while keeping the required embedment at each level. The same total face area can therefore create a very different cutting pattern.

Why complex walls need a layout, not only an area

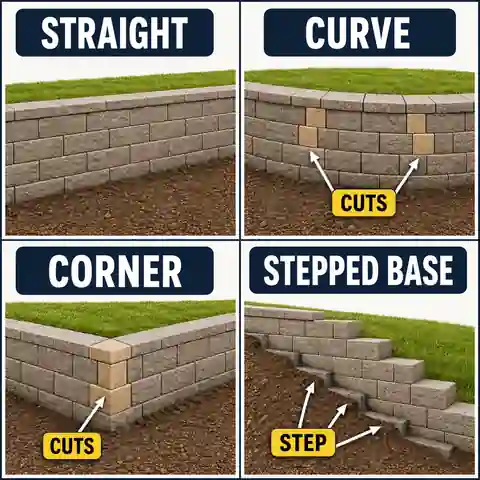

Retaining wall layout comparing a straight run, curve, corner and stepped base with block cuts

Measure a curved wall along the planned face or centreline required by the block system, not across the chord.

Check minimum-radius rules before assuming every standard unit fits the curve.

Count corner and end units separately when the system uses special pieces.

For a stepped wall, calculate each constant-height section and base step so buried-course blocks are not lost from the estimate.

The Curve Was Free on the Sketch

  1. Dera Plannerplanning, budget and common sense

    The curved section looked much nicer on paper, so we added it in about three seconds.

  2. Dera Builderhands-on view of outdoor construction

    The blocks have since requested a minimum radius, more cuts and a serious conversation with the cap units.

    Apparently curves are only free when drawn with a pencil.

Turn Piece Counts Into Pallets and Deliveries

The calculator can tell you that the wall needs 178 regular blocks. The supplier may sell 48 blocks per pallet, only full pallets for delivery, or a mixture of full pallets and loose units for collection. Caps may be packaged separately. Stone may have a minimum loose-load or bulk-bag quantity. The useful final step is to convert the geometric estimate into the units that can actually arrive at the site.

Build the final shopping list

ItemCalculator resultSupplier check
Regular wall blocksWhole units including buried courses and allowanceBlocks per pallet, loose-unit availability, colour or production batch and unit weight
Corner or special unitsLayout-specificSeparate product code and orientation
Caps / copingSeparate top-row countCaps per pallet, corner cuts, adhesive or fixing detail
Base aggregateCubic volumeSpecified product, bulk density, minimum load and compaction allowance
Drainage aggregateSeparate cubic volumeClean/free-draining specification, bulk density and whether block cores also require fill
Drain pipe and fittingsLinear route plus project allowancePipe specification, fittings, outlet components and roll or stick lengths
Geotextile or filter layerOnly if specifiedGrade, width, overlap and burial suitability
GeogridNot guessed by this material estimateDesigned layers, length, strength and connection for the selected wall system

178 Blocks Look Smaller in a Spreadsheet

  1. Dera Builderhands-on view of outdoor construction

    The spreadsheet says 178 blocks. That seems manageable.

  2. Dera Plannerplanning, budget and common sense

    Good. Now multiply by the actual unit weight and decide where the delivery truck can unload them without converting the lawn into a second excavation project.

  3. Dera Builderhands-on view of outdoor construction

    The number has become noticeably heavier.

Complete Worked Example: 30 ft Long × 3 ft High

The example below uses the same simple planning assumptions as the HomDera calculator so every line can be checked. It is a material takeoff, not an installation prescription. Replace the block size, embedment, base and drainage dimensions with the actual selected wall-system details before ordering.

Example inputs

InputValuePlanning note
Wall length30 ftStraight run
Exposed height3 ftFinished grade to top of regular wall courses
Regular blockAbout 16 in face length × 6 in course height × 10 in depthMedium HomDera preset
Buried courses1Planning value only
Material allowance10%Applied to the example purchase quantities
Cap length16 in for illustrationUse the actual cap product
Compacted base depth6 inHomDera planning input
Planning base widthAbout 22 inBlock depth plus about 12 in total extra width in the calculator model
Drainage-zone thickness12 inHomDera planning input

Example material results

QuantityCalculationResult
Blocks per course360 in ÷ 16 in22.5 → 23 blocks
Visible courses36 in ÷ 6 in6 courses
Total courses6 visible + 1 buried7 courses
Regular blocks before allowance23 × 7161 blocks
Regular blocks with 10%161 × 1.10177.1 → 178 blocks
Cap positions before allowance360 in ÷ 16 in22.5 → 23 caps
Illustrative caps with 10%23 × 1.1025.3 → 26 caps
Base aggregate30 ft × 22/12 ft × 6/12 ft × 1.10About 1.12 yd³
Drainage aggregate30 ft × 1 ft × 3.5 ft × 1.10About 4.28 yd³
Drain routeApproximately the wall run before fittings and allowanceAbout 30 ft, subject to the actual drainage design

The striking number is not 178 blocks. It is the contrast between roughly 1.12 yd³ of base aggregate and about 4.28 yd³ of drainage aggregate in the simplified section. The material nobody sees after completion can occupy the larger part of the delivery. That is exactly why a retaining wall estimate should not stop at blocks per square foot.

US, UK and Other English-Speaking Market Terms

The calculation works everywhere, but the words on a supplier invoice can change. Use both the regional term and the technical function when searching, especially for aggregate. A product called wall rock in one market may be sold as clean drainage aggregate or single-size stone somewhere else.

Common retaining wall vocabulary

MarketWall and top unitsAggregate and delivery language
United States / CanadaRetaining wall block, SRW unit, cap blockWall rock, clean stone, drainage stone, road base; cubic yard, short ton or tonne depending supplier
United Kingdom / IrelandRetaining wall block, segmental walling, coping or coping unitGranular sub-base, Type 1 where specified, drainage aggregate, shingle, single-size stone; m³, tonne or bulk bag
Australia / New ZealandRetaining wall block, segmental block, capping unitCompacted base, drainage aggregate, crushed rock or local quarry names; m³ and tonne
Any marketUse the exact manufacturer's product name and dimensionsAsk for grading, fines, bulk density and intended use rather than relying on the nickname alone

Common Retaining Wall Estimating Mistakes

Mistake, consequence and better approach

MistakeWhat goes wrongBetter check
Using only wall areaRepeated partial blocks and whole-course rounding are hiddenCount blocks per course and courses separately
Forgetting buried coursesThe first course arrives short before the wall is even visibleAdd the required embedment to the installed height and block count
Using the block's nominal name as a dimensionRow and course counts can be wrongUse actual installed face length and course height
Assuming caps equal regular blocksThe top row is short or over-orderedUse the actual cap or coping length
Combining base and drainage gravelThe supplier quote cannot be checked and the wrong aggregate may be usedCalculate and specify the two volumes separately
Converting cubic yards to tons with one universal numberWeight can be materially wrongUse the supplier's density or conversion
Assuming a 6 in base or 12 in drainage zone is universalThe takeoff no longer matches the chosen systemUse the manufacturer or project detail
Guessing geogrid from wall heightThe reinforcement may be completely unsuitableUse the system design or qualified project design
Ignoring surface water and the outletA correct material quantity can still leave water trapped behind the wallPlan grading and drainage as part of the site
Ordering by pieces but ignoring pallet weight and accessThe material reaches the property but not the work areaCheck unloading, storage and handling before delivery

Frequently Asked Questions

How many retaining wall blocks do I need for a 20 ft × 3 ft wall?

With 16 in long × 6 in high face units, one buried course and 10% allowance, a 20 ft wall needs 15 blocks per course and seven total courses. That is 105 blocks before allowance and 116 blocks after rounding the 10% purchase quantity up. Different block dimensions or embedment change the answer.

How much extra should I add for retaining wall blocks?

For a simple straight wall, roughly 5–10% can be a useful planning reserve when the supplier and layout support it. Curves, steps, corners, frequent cuts, breakage risk or special colour selection can justify more. A layout-based allowance is better than automatically adding the same percentage to every project.

Is one buried course always enough?

No. One buried course is a useful default for a quick estimate, not a universal construction rule. The required embedment depends on the selected wall system, wall height, slope, erosion exposure, finished grade and project design.

How much gravel should go under retaining wall blocks?

There is no single depth or width for every product. Once your wall detail gives the compacted base width and depth, multiply those dimensions by wall length to obtain volume. Some manufacturer details use approximately 4–6 in (100–150 mm) of compacted granular base in common residential conditions, while other systems and sites differ. Use the current detail for the exact wall being built.

How much drainage gravel is needed behind a retaining wall?

Use the specified drainage-zone thickness, wall length and installed height. A 12 in (300 mm) zone is common in some segmental wall systems, but it is not universal. The selected block system may also require aggregate inside hollow units or additional drainage details, so check the complete section rather than one dimension from a generic guide.

Does every retaining wall need a perforated drain pipe?

Not every manufacturer uses the same rule for every wall condition. Pipe requirements can change with wall height, reinforcement, soil, slope and drainage conditions. What every project does need is a deliberate water-management plan so surface water and subsurface water are not trapped behind the structure.

When does a retaining wall need geogrid?

The answer depends on the selected block system and the complete site conditions. Height, soil, slope, surcharge, groundwater, terraces and nearby structures all matter. Do not choose geogrid layers from a generic height table unless that table belongs to the exact approved system and conditions being built.

Can I use ordinary concrete blocks instead of retaining wall blocks?

Not as a direct substitution. Mortared or reinforced concrete masonry can be used in engineered retaining structures, but its foundation, reinforcement, drainage, waterproofing and structural design are different from a dry-stacked segmental retaining wall system. Choose the wall type first, then calculate materials for that system.

Manufacturer References: Useful Examples, Not Universal Dimensions

Manufacturer guides are useful because they show how base depth, embedment, drainage aggregate and pipe details belong to a complete wall system. They also show why copying one dimension from a different product is risky. The references below are examples from two English-speaking markets; use the current documentation for the exact product installed on your project.

Allan Block: basic segmental retaining wall installation and drainage detailsTobermore: Secura Grand retaining wall installation guidelines

Final Retaining Wall Order Check

  • The wall run has been measured along the real planned face, including curves and steps.
  • Exposed height and finished grades are clear along the full wall.
  • Regular block face length, course height and depth come from the exact selected product.
  • The required buried course or embedment has been included in the block count.
  • Blocks per course and total courses have both been rounded correctly.
  • Caps or coping units have their own count and product dimensions.
  • Base aggregate and drainage aggregate are separate quantities and specifications.
  • Aggregate tonnage or tonnes use the supplier's real density or conversion where available.
  • Drainage pipe, outlet, surface grading and groundwater conditions have been reviewed as one water-management problem.
  • Geogrid has not been guessed from wall height alone.
  • Corner units, steps, curves, cuts and special pieces are listed separately.
  • The order has been converted into actual pallets, loose units, bulk bags or truckloads.
  • Delivery access, unloading area, block weight and dry or clean storage have been planned.
  • The final takeoff has been checked against the selected manufacturer detail or project design before excavation.

The reliable answer to “How many retaining wall blocks do I need?” is not one blocks-per-square-foot shortcut. Count the wall by courses, include the part hidden below grade, calculate the top units separately, then treat the base and drainage stone as two different bulk-material orders. After that, turn the neat numbers into real pallets and deliveries.

That sequence takes a few minutes longer than multiplying length by height, but it is much more useful when the truck arrives. The finished wall may show only the attractive face and caps. Your budget, your wheelbarrow and possibly your lower back will remember everything behind them.

Open the HomDera Retaining Wall Calculator
All Guides & Articles
How Many Retaining Wall Blocks Do I Need? Blocks, Caps, Base Gravel and Drainage | HomDera
